AI Consulting Engagement Models: PoC vs Project vs Retainer

UK AI adoption has almost tripled since 2023, but only 10% of adopters use AI extensively. That gap is usually the contract shape, not the technology. How PoC, project and retainer really differ.

AI Consulting Engagement Models: PoC vs Project vs Retainer

By Ivan Pylypchuk, CEO of SoftBlues. Has led Claude implementations from proof of concept to production for finance, legal and healthcare teams across the UK and Ireland.

UK businesses have adopted AI almost three times over in under three years, and barely gone any deeper. The share of firms with 10 or more employees using at least one AI technology rose from around 12% in late 2023 to around 35% in June 2026, yet the average adopting business still runs only 1.6 AI technologies, up from 1.4, and just 10% of adopters say they use AI extensively (ONS, July 2026). Wide, shallow adoption is not really a technology result. It is a contracting result.

AI consulting engagement models are the contract shapes a buyer can choose from: a fixed-price discovery, a proof of concept, a fixed-scope build project, a monthly retainer, or an embedded team. Each carries a different cost profile, a different risk owner and a different exit. Pick the shape that matches how certain you are, not the one the vendor prefers.

At SoftBlues, an AI consulting firm working with regulated mid-market companies across the UK and Ireland, we quote most first engagements as a fixed-price piece of work that ends in a named decision, because the shape of the contract usually decides whether anything reaches production.

Key facts

  • There are five shapes in practice: discovery, proof of concept, fixed-scope project, retainer, and embedded team. Everything else is a variation.
  • Depth is the UK's real gap. Adoption reached around 35% of businesses with 10 or more employees by June 2026, but only 10% of adopters use AI extensively and only 11% have trained more than half their workforce (ONS, July 2026).
  • Spending does not fix it. MIT's Project NANDA found 95% of organisations getting zero return despite $30 billion to $40 billion of enterprise generative AI investment, and put the divide down to approach rather than model quality (MIT Project NANDA, July 2025).
  • Our proof of concept is a fixed £20,000 over about two months and ends in a go or no-go, not a demo (our data, August 2026).
  • Our implementation retainer runs £10,000 to £20,000 per month and only makes sense once something is live (our data, August 2026).
  • The commonest failure is a well-run PoC with nobody accountable for production. It proves the technology and changes nothing.

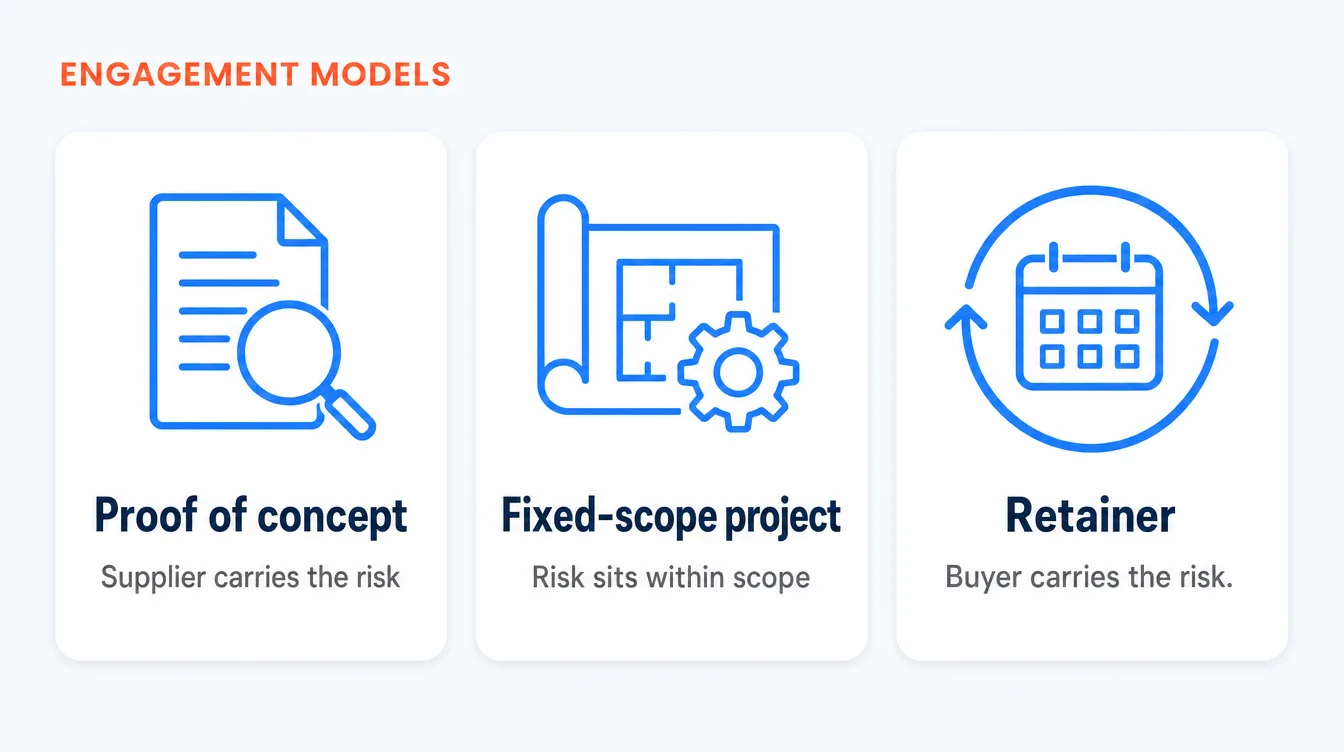

  • Three cards comparing AI consulting engagement models by who carries the risk: on a proof of concept the supplier carries the risk, on a fixed-scope project the risk sits within the agreed scope, and on a retainer the buyer carries the risk.

    Who this is for, and who it isn't

    This is for a CEO, COO or CTO at a 50-to-500-person UK or Ireland company, often in finance, legal, healthcare or professional services, who has agreed a budget and now has to choose the shape of the contract.

    It is not for a team still deciding whether to use AI at all, and it is not a pricing benchmark. If you are setting a budget rather than picking a contract, read our breakdown of what AI consulting actually costs in the UK first. If you already know your model and need to check the paperwork, go to what belongs in an AI consulting proposal.

    Why does the engagement model matter more than the day rate?

    Because the day rate tells you what an hour costs, and the engagement model tells you who pays when the work takes longer than anyone thought. On AI work it almost always does. Usually the data is messier than the demo suggested, or the compliance sign-off nobody scheduled takes three weeks.

    A fixed price puts that overrun on the supplier. Time and materials puts it on you. A retainer puts it on neither, which sounds fair and quietly means it lands on whoever is less organised. None of those is wrong. They are different bets, and you should place the one that matches your uncertainty.

    💡Tip
    The more uncertain the outcome, the more you want a fixed price and a short clock. The more certain the outcome, the more a flexible model saves you money.

    What are the main AI consulting engagement models?

    Five shapes cover almost every AI consulting engagement in the UK market. What separates them is the cost profile, who absorbs an overrun, how fast you see something real, and how cleanly you can walk away.

    ModelCost profileWho carries the riskSpeed to first real outputHow you exit
    Discovery / auditFixed fee, smallSupplier2 to 4 weeksEnds automatically with a document
    Proof of conceptFixed fee, cappedSupplierAbout 2 monthsEnds on a go or no-go decision
    Fixed-scope projectFixed fee, large, stagedSupplier, within the agreed scope6 to 12 weeks for the first releaseEnds at acceptance of the final stage
    RetainerMonthly, rollingShared, and in practice the buyerOngoing from month oneNotice period, usually 30 to 60 days
    Embedded teamMonthly per personBuyerAs fast as you can direct themNotice period per person
    ModelBest forAvoid if
    Discovery / auditYou know something is inefficient but cannot yet name the use case, the data owner or the compliance pathYou have done this internally and only want it validated. That is a two-day review
    Proof of conceptOne named use case, real data you can share, and a real willingness to stop if the answer is noThe decision to build has already been made politically. Then you are paying for theatre
    Fixed-scope projectA validated use case with agreed acceptance criteria and a production owner already namedThe requirements are still moving. Fixed scope plus moving requirements produces change requests, not software
    RetainerSomething is already live and needs improving, monitoring and extending as priorities shiftNothing is live yet. A retainer without a shipped system funds exploration indefinitely
    Embedded teamYou have your own technical leadership and need specific capability at speedYou need someone else to own the outcome. Embedded engineers deliver what you direct

    Not sure which shape fits? A 30-minute discovery call is enough for us to say which of these five we would recommend, and which we would talk you out of. You leave with a shape, an indicative price band and the questions to put to any other supplier you are speaking to. Book a discovery call.


    What is the difference between a proof of concept and a pilot?

    A proof of concept answers "can this work at all", using real data, on a fixed clock, for a small group who know they are testing something. A pilot answers "does this work in our operation", with real users doing real work, at limited scale, with the support and training a live system needs.

    They are different purchases. A PoC that succeeds tells you the technology is viable. It does not tell you your people will use it or that your compliance team will sign the evidence trail. Getting past the pilot is a separate piece of work, and it is the one the ONS depth figures say most firms never bought. Our guide to running a proof of concept that reaches production covers that plan in detail.

    Warning
    If a supplier uses "PoC" and "pilot" interchangeably in a proposal, ask which one you are buying and who the users will be. The answer usually reveals whether anyone has thought about production.

    Where does each engagement model quietly fail?

    Every shape has a characteristic failure, and it is rarely dramatic. It looks like a project that quietly stops mattering.

    The PoC that never ships. The most common by far. The build works, the demo lands well, and then nobody owns the next step. No production budget was reserved, no internal owner was named, and the kill criteria were never written, so the result cannot even be called a failure. It just sits there. The fix is unglamorous: before the PoC starts, write down the success metric, the kill criteria, and the name of whoever owns production if it passes.

    The project that delivers the wrong thing correctly. Fixed scope locks the requirements at the point when you understood the problem least. Six months later you accept a system that meets every criterion and solves a problem that has moved.

    The retainer that becomes a subscription. Month one is useful. By month seven nobody can say what the retainer produced last quarter, and it renews because cancelling requires a conversation.

    The embedded team with no destination. Capable engineers, well managed day to day, no architecture owner. Eighteen months later you have five working things that do not fit together.

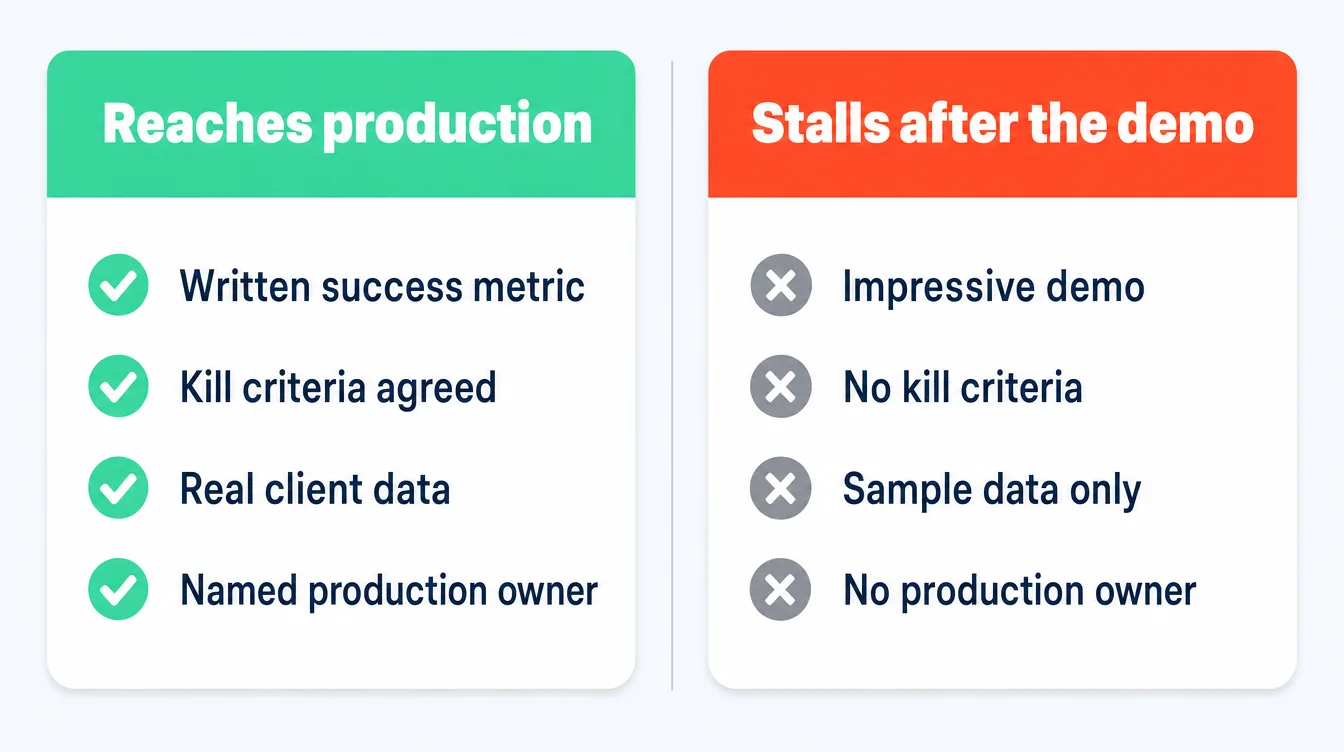

    Two-column comparison of a proof of concept that reaches production against one that stalls after the demo. The first has a written success metric, agreed kill criteria, real client data and a named production owner. The second has an impressive demo, no kill criteria, sample data only and no production owner.


    What does each engagement model cost in the UK?

    These are our own indicative bands as of August 2026, traced to our rate card rather than to a published market benchmark. Market day rates sit well above them, roughly £900 to £1,600 at mid-tier UK firms and £2,000 to £5,000 at the large management consultancies, which we cover in the AI consulting costs guide.

    ModelIndicative price (our data, Aug 2026)Typical duration
    Discovery / audit£10,000 to £20,000 fixed2 to 4 weeks
    Proof of concept£20,000 fixedAbout 2 months
    Fixed-scope production programmeAround £320,000 to £355,000 for a full 12-month build, staged6 to 12 months
    Implementation retainer£10,000 to £20,000 per monthRolling
    Embedded engineer£4,900 to £8,600 per person per month, by seniority12 months or more

    The word staged matters more than the number. A twelve-month programme should be billed against named releases, not evenly across the year, so that stopping after stage two costs you stage two rather than the year.

    What does this look like in a regulated firm?

    Take a financial planning firm with 40 advisers that wants to automate its monthly client file review. The sequence is the product.

    A discovery at £15,000 maps the process, the data sources and the evidence trail a reviewer would need. A £20,000 proof of concept then runs for about two months against real files and answers one question: does the output survive a compliance reviewer's spot check? If it does, a staged build follows. If it does not, the firm has spent £35,000 to avoid committing a six-figure programme to something that would not have held up (our data, indicative).

    The regulatory point is unchanged by any of this. Under the FCA's Senior Managers and Certification Regime, accountability sits with a named individual and does not transfer to a model (FCA). So the system drafts and evidences, and a named human signs off. We use it before we sell it: we run our own company this way across six internal departments, documented in our Claude operating system case study.

    What are the red flags in how a proposal is shaped?

    A retainer proposed before anything is live. Reasonable for support, a warning sign for a first engagement.

    A PoC with no written kill criteria. If nothing would count as failure, you are not buying a test.

    Fixed price with an open scope. The change requests are the business model.

    No named production owner on your side. A good supplier asks for one before you offer.

    A day rate with no estimated day count. A £40,000 engagement is twenty senior days or fifty junior ones. Different purchases, same price.

    How should you choose? A four-point checklist

    1. Name the decision this engagement has to produce. Not the deliverable, the decision. "Do we build this" is a decision. "A report" is not.

    2. Say honestly how certain you are. High uncertainty points to discovery or a PoC. Low uncertainty points to a fixed-scope project. Real ongoing change points to a retainer.

    3. Name the production owner before you sign. If you cannot name one, buy discovery, not a build.

    4. Confirm who pays for an overrun, in writing. The answer tells you more about a supplier than their case studies do.


    We put Claude into production in 90 days at a fixed price, with money back if the proof of concept fails, and we would rather sell you a £20,000 test than a programme you are not ready for. If the use case is an operational one, you can see how we approach business process automation.

    For a straight answer on which model fits your situation, book a discovery call. Thirty minutes, no deck.

    Frequently asked questions

    What are the main AI consulting engagement models?

    Five: a fixed-price discovery or audit, a proof of concept, a fixed-scope build project, a monthly retainer, and an embedded team. They differ in cost profile, who absorbs an overrun, how quickly you see real output, and how cleanly you can stop.

    Is a proof of concept worth the money if we might not proceed?

    That is exactly when it is worth it. A £20,000 PoC that produces a clear no-go has done its job, because the alternative is committing a six-figure build on an assumption. It only wastes money when the decision to proceed was already made before it started.

    How long should an AI retainer run before we review it?

    Review it quarterly and ask one question: what shipped. If the answer is unclear two quarters in a row, the retainer has become a subscription. We would rather restructure it than renew it quietly.

    Can we start with a retainer instead of a project?

    You can, and it usually goes badly as a first engagement. A retainer suits improving something that already exists. With nothing live, the monthly fee funds open-ended exploration, and open-ended exploration is what produces the shallow adoption the ONS data shows.

    Who owns the code and the models we pay for?

    Ask this before you sign, whoever you use, and get the answer into the statement of work rather than the sales call. Some suppliers hand over everything, others retain platform or reusable-component rights. Both are legitimate, but they are different purchases, and the difference rarely shows up in the price.

    Does the engagement model change in a regulated sector?

    The shape does not, but the discovery gets longer and the evidence requirements get written into the acceptance criteria. In UK financial services, accountability under SM&CR stays with a named person regardless of how the work is contracted, so any model you choose has to keep a human sign-off step in the process.

    What if our requirements change mid-project?

    Then a fixed-scope project was the wrong shape, and it is worth saying so early. Staged delivery with a decision point between stages handles real change far better than a change-request process bolted onto a fixed contract.
